Skip to content
Jber Coffee LimitedGreen Coffee · Origin Supply

Quality

Quality Assurance

Eleven steps from lot selection to a sealed container. Each has a defined output and a characteristic failure mode, and the results are reported with the methods stated so they are comparable with your own analysis.
  1. Origin and lot selection
  2. Pre-shipment sample drawn
  3. Physical analysis — moisture, water activity, density
  4. Screen and defect count
  5. Cupping against the approved sample
  6. Preparation adjustment if required
  7. Final pre-shipment sample
  8. Loading supervision and seal record
The pre-shipment quality control sequence.

Workflow

What happens at each step

Written as an operational description rather than as a promise. Where a step depends on the station rather than on us, it says so.

  1. 01

    Sourcing

    Identifying stations, factories and mills that can meet the specification, and confirming the crop actually supports it before anything is offered. This is where a requirement that cannot be filled should be identified — not at shipment.

  2. 02

    Cherry and lot selection

    At station level: floatation and hand sorting at reception, and the delivery-day separation that makes tighter lots possible. Everything downstream is limited by what is accepted here, because no later step removes an under-ripe cherry.

  3. 03

    Processing

    Pulping clearance, fermentation endpoint judged by feel rather than by clock, washing and channel grading, and the clean-water soak where the origin uses one. Failure modes here are sour, phenolic and dull cups.

  4. 04

    Drying

    Layer depth, turning frequency, shade management and the discipline of the final days — where over-drying happens because the coffee looks finished before it is. Dried to target moisture, then rested before hulling.

  5. 05

    Hulling

    Parchment removed from washed coffee, or skin, pulp and parchment together from naturals. Equipment settings matter: over-aggressive hulling chips the bean, which is both a defect class and an entry route for moisture in storage.

  6. 06

    Grading

    Pre-cleaning, screen separation by bean width, density separation on the gravity table, and colour sorting. This is where the contracted grade and screen are actually produced.

  7. 07

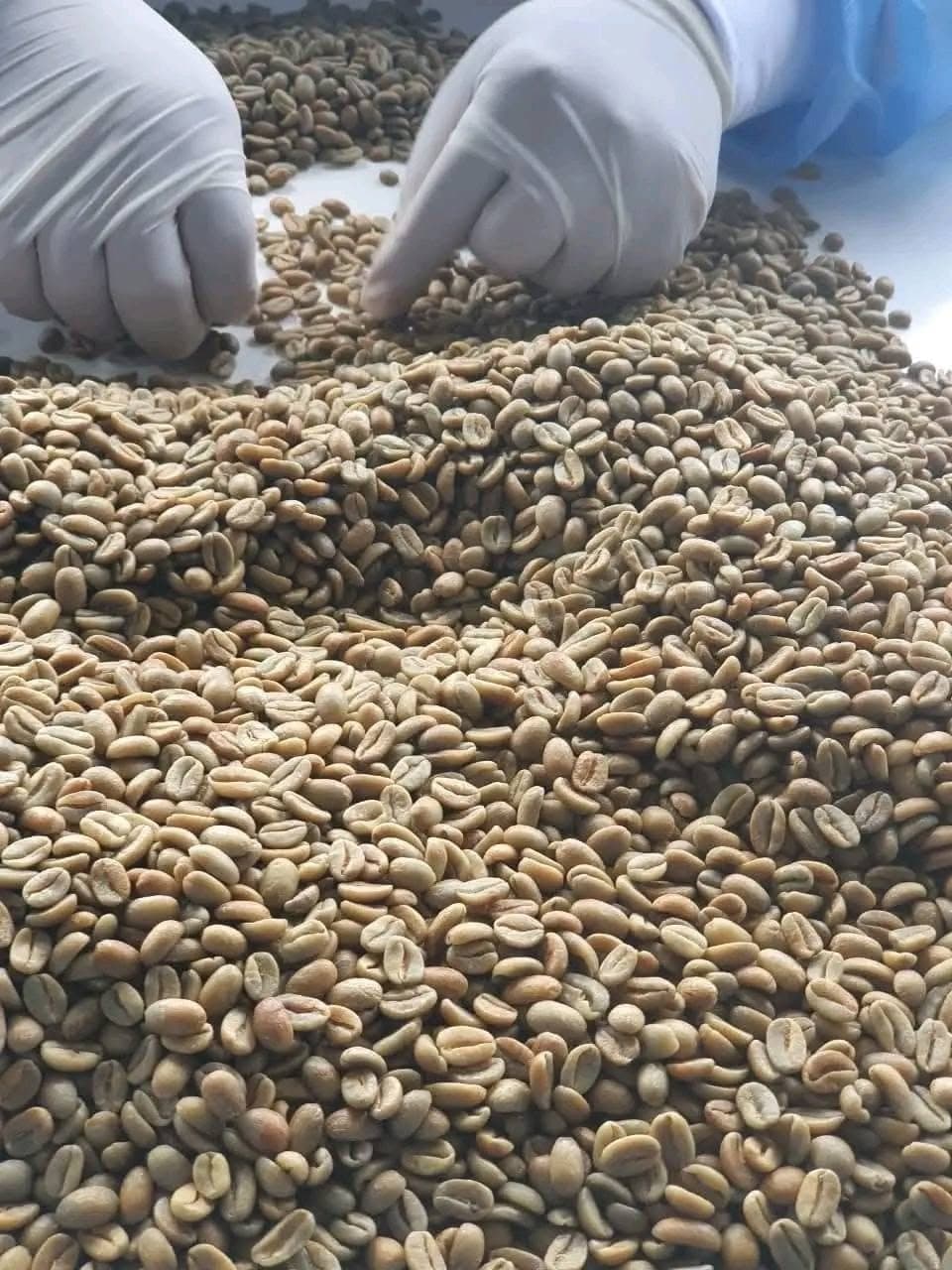

    Defect analysis

    A drawn sample picked over by hand, faults categorised and converted to full defect equivalents against the stated weighting table. Reported with the counting basis so it is comparable with the buyer’s own analysis.

  8. 08

    Moisture and water activity

    Measured on the same sample draw, with the method and instrument stated. Water activity is reported alongside moisture where storage duration matters — normal moisture with elevated water activity points at uneven drying.

  9. 09

    Cupping

    Multiple cups per sample, blind where practical, against the approved reference. Multiple cups is not optional: bean-level faults such as potato taste or a single phenolic bean will not appear in one cup.

  10. 10

    Pre-shipment inspection

    A sample drawn from the milled parcel to the agreed sampling method, analysed and cupped against the approved sample. Independent survey arranged where the contract or the payment terms require it.

  11. 11

    Loading

    Container inspected before stuffing — dry, clean, odour-free, no light through the seams. Lined and desiccated for the voyage, stuffed under supervision, with bag count, weights, seal number and photographs recorded.

Reporting

What a pre-shipment report contains

Every figure is reported with the method behind it. A number without a method is not comparable with your own measurement, which is where most arrival disputes begin.

Pre-shipment report fields
MeasurementWhat is reportedWhy the method matters
MoisturePercentage plus instrument and methodCapacitance, resistance and oven methods disagree by enough to argue about — see green coffee moisture
Water activityaw plus measurement temperatureaw is temperature dependent; the reading is meaningless without it
Screen analysisPercentage retained per screen, and the sample sizeScreening is statistical, not absolute — see coffee screen sizes
Defect countFull defects per defined sample, plus the weighting table usedCounts from different systems are not directly comparable
DensityBulk density in g/L, plus the fill procedureFill method changes the reading substantially
CupNotes per cup, faults noted separately, protocol named where scoredA score without a protocol and a calibrated panel carries little information
Loading recordBag count, weights, seal number, photographsThe evidence base for any arrival claim

Sampling is the whole game

Every figure a report contains describes the sample, not the parcel. If the sample was drawn badly, the analysis is precise about the wrong thing. The sampling method — proportion of bags, draws per bag, compositing, final sample size — belongs in the contract alongside the tolerances.

What physical analysis cannot catch

Ferment, phenolic and mould taints — particularly in naturals — leave little or no visible trace in the green bean. A parcel can pass a screen and defect analysis cleanly and still be unusable. Physical analysis and cup approval are complementary controls, not alternatives, which is why every lot is cupped.

Documentation

Laboratory results and certificates

Where a contract or a destination requires laboratory analysis — residues, contaminants or a certificate of analysis — we arrange it through accredited laboratories and provide the results as part of the document set. The architecture of this site supports publishing lot-level laboratory documents against a lot record once an inventory source is connected; until then, results are supplied directly with the shipment documentation.
